  • The East York Home Addition That Almost Didn’t Happen

    The East York Home Addition That Almost Didn’t Happen

    How a Dormant 2022 Permit Became a 700 Sq Ft Transformation in East York

    Three years of waiting, one aggressive start date, and a team that asked the right questions from day one.

    Evan and Kelly had a building permit for their East York home addition sitting dormant since 2022 — stalled by rising costs and a string of home builders who couldn’t give them straight answers. BVM Contracting took over in 2026, protected the at-risk permit with a strategically timed inspection, navigated a months-long Enbridge gas meter relocation, and managed multiple design revisions with Replacement Design — all without losing a single day on the construction schedule. The result: a home that grows from 1,600 sq ft to 2,300 sq ft, with a full second floor, a main level extension, and a finished basement with full bathroom. All in for approximately $680,000–$700,000.

    Project Information

    To be filled in

    The Permit That Nobody Could Activate

    When Evan and Kelly first reached out to BVM Contracting in December 2025, they weren’t starting from scratch. They had a building permit in hand — issued by the City of Toronto back in 2022 — for a substantial home addition at 349 Dawes Road in East York. What they didn’t have was a builder who could actually make it happen.

    The permit had been dormant for over three years. Rising construction costs and climbing interest rates in 2022 had priced them out of moving forward, and every contractor they’d spoken to since had been vague on scope, fuzzy on budget, or unwilling to engage honestly with the complexity the project required. The permit was an asset — but under City of Toronto rules, a permit can be inactivated if a project doesn’t commence within a specified period. With an aggressive start date locked in and no room for bureaucratic surprises, the risk was real.

    Our team flagged it on day one. We called the building inspector directly, confirmed exactly what was needed to protect the permit, and locked in the first inspection early — making it impossible for the city to close the permit before construction got underway. For Evan and Kelly, it was the first time a contractor had shown up with answers instead of uncertainty.

    Bottom line: Identifying permit risk before breaking ground isn’t just project management — it’s the difference between a project that starts on time and one that loses months to a problem that should never have been a problem.

    700 Square Feet That Changes Everything

    Here’s what Evan and Kelly are actually getting: a home that doesn’t look, feel, or function anything like the one they’ve been living in.

    The project includes a ~200 sq ft extension on the main level — expanding the footprint and creating the structural base for what comes above. On top of that sits a full second floor top-up of 755 square feet. That’s the transformation that changes everything. What was previously a cramped half-storey second level becomes a proper, full-height floor. Rooms that were undersized become real rooms. Circulation that was squeezed opens up. The family gains a second floor that actually works the way a second floor should.

    In the basement, what was underutilized rough space becomes a fully finished living level: a rec room, a full bathroom, and a dedicated laundry area. During pre-construction, our team ran both scenarios in the preliminary budget — fully finishing the basement versus roughing in the mechanicals and leaving finishes for a later phase. We’ve done that approach before on other projects when it’s the right move for the client’s budget. Evan and Kelly reviewed the numbers, understood the cost difference clearly, and decided to do it right the first time. Because doing a second renovation later almost always costs more than finishing it now.

    When it’s done, 349 Dawes Road goes from approximately 1,600 sq ft to approximately 2,300 sq ft — 700 additional square feet this family will live in for decades.

    Bottom line: 700 square feet of new space isn’t just more room — it’s a fundamentally different home, designed around decisions the clients made with full cost visibility at every step.

    The Gas Meter, the Redesigns, and Everything That Had to Go Right

    No addition of this scope is just a construction story. Getting to a clean start at 349 Dawes Road required managing two parallel challenges — a utility relocation and multiple design revisions — without letting either one compromise the project timeline.

    The gas meter relocation was the higher-stakes of the two. Whenever Enbridge gets involved, the project timeline is at risk. The relocation required coordination between NPL, Enbridge, the City, and the homeowners, and the process stretched over several months with no guaranteed end date. Our team identified the risk early and stayed on every stakeholder to keep things moving. The gas line was successfully cut off right as construction began in May 2026 — not a day early, not a day late. The project didn’t lose a single day to utility delays.

    The design revisions were a different kind of challenge. After receiving BVM’s detailed, itemized scope of work, Evan and Kelly were able to see exactly how specific design decisions were driving cost. Things like pocket doors, siding selections, and basement shower configurations suddenly had real dollar values attached to them — and some adjustments needed to be made. The basement shower was revised to a more efficient prefab unit. Interior door types were updated. The main entrance roof overhang was extended to add proper weather protection at the front entry — a functional improvement that also improved the design. The deck scope was refined. Every change made the home more practical for the family and kept the project financially sound. A revised permit resubmission was completed in time to hold the construction start date.

    These aren’t complications. This is what rigorous pre-construction planning actually looks like when it’s done right.

    Bottom line: Every complexity on this project — permit risk, gas relocation, design revisions — was identified early, managed proactively, and absorbed without a single day of delay to the construction schedule.

    Why Evan and Kelly Finally Said Yes — After Three Years

    Evan and Kelly found BVM Contracting on Google. After that, the story gets more interesting.

    They had been living with this permit for three years. They weren’t waiting because they’d changed their minds about the addition. They were waiting because nobody had been able to give them the clarity and assurance they needed to actually sign a contract. Budget conversations went vague. Scope questions got deflected. No contractor had ever truly challenged their thinking or mapped out what the project actually required.

    The first few conversations with BVM were different. Our team asked the questions no one else had bothered to ask — about the permit status, about the basement options, about what the project would actually cost under different scenarios. We gave Evan and Kelly the breakdown of their biggest cost decisions so they could see the impact of each one. We connected them with past clients. We held multiple budget review sessions. We answered hundreds of questions — not as a courtesy, but because that’s the minimum level of engagement every family who works with us should expect.

    Homeowners care about cost, but more than anything, they care about assurance. Will the number we start with be the number we end with? And if you can’t prove that — not just promise it, but prove it with your process, your track record, and your history of transparency — then your word means nothing.

    For Evan and Kelly, the proof was in the process. Long before construction ever started.

    Bottom line: Three years of waiting ended not because the market got better, but because they finally found a team that operated with full transparency and earned their trust before asking for a signature.

    Before & After (Photos to come)

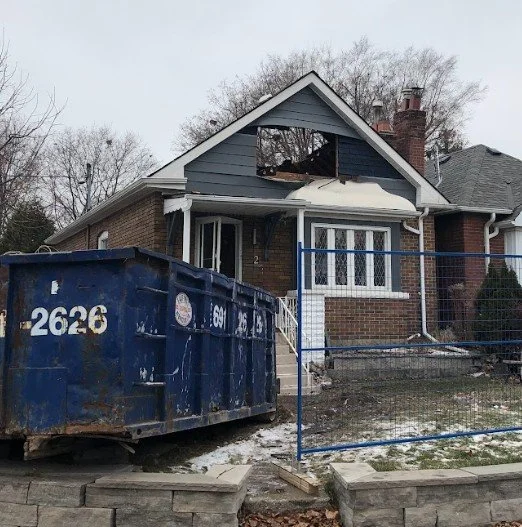

    Before: A ~1,600 sq ft East York home with a half-storey second level, an underutilized basement, and a building permit from 2022 that had been sitting inactive for over three years — and a family that wanted the addition but couldn’t find a contractor they could trust.

    After: A ~2,300 sq ft fully transformed home — full-height second floor, main level extension, finished basement with full bathroom, rec room, and laundry — built on an aggressive timeline, with a permit protected and a gas relocation coordinated in time for day-one construction. All-in budget of approximately $680,000–$700,000.

    Ready to Start Planning Your Home Addition?

    The 349 Dawes Road project is exactly what a complex home addition looks like when it’s planned properly — permit strategy, utility coordination, value engineering, multiple design revisions, and construction that starts on schedule and stays there.

    If you’re considering a home addition in East York, Scarborough, or anywhere in the GTA — especially if you have an existing permit, a complicated site, or a project that other contractors have struggled to scope clearly — our pre-construction process gives you the certainty you need before committing to anything.

    Want To Start Your Home Addition Journey?

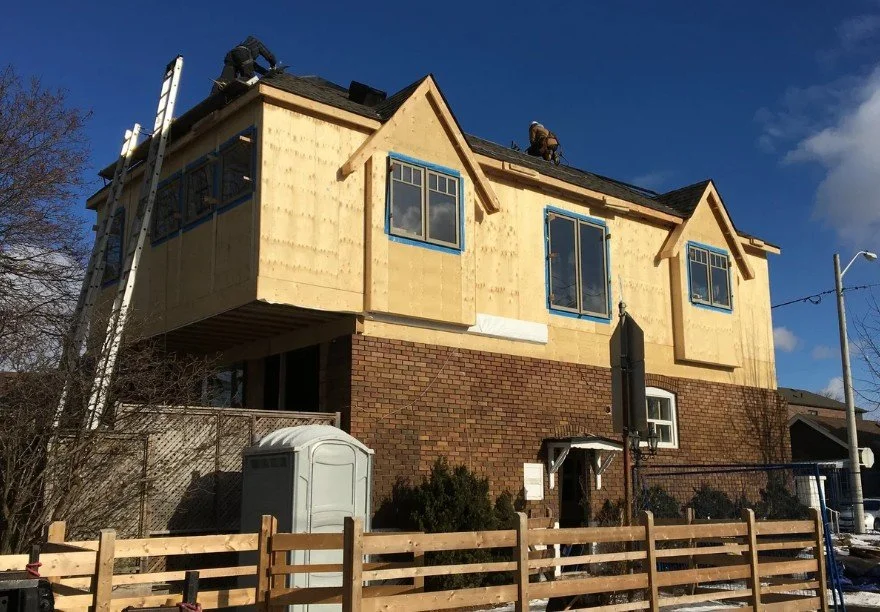

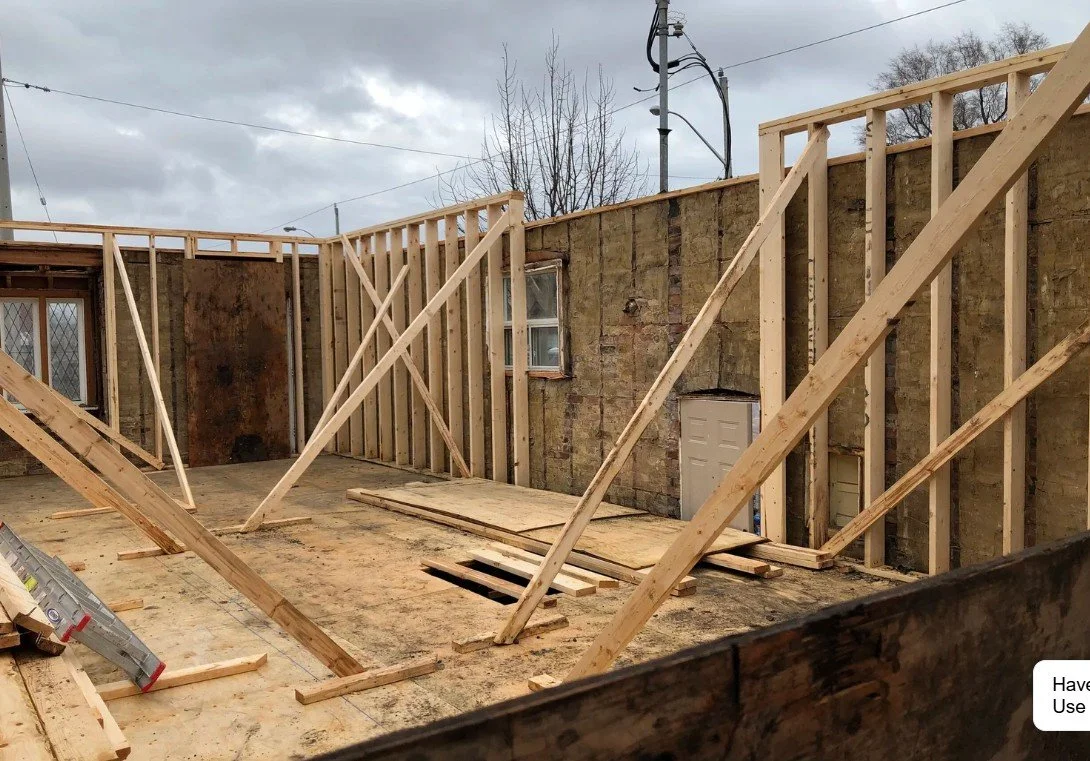

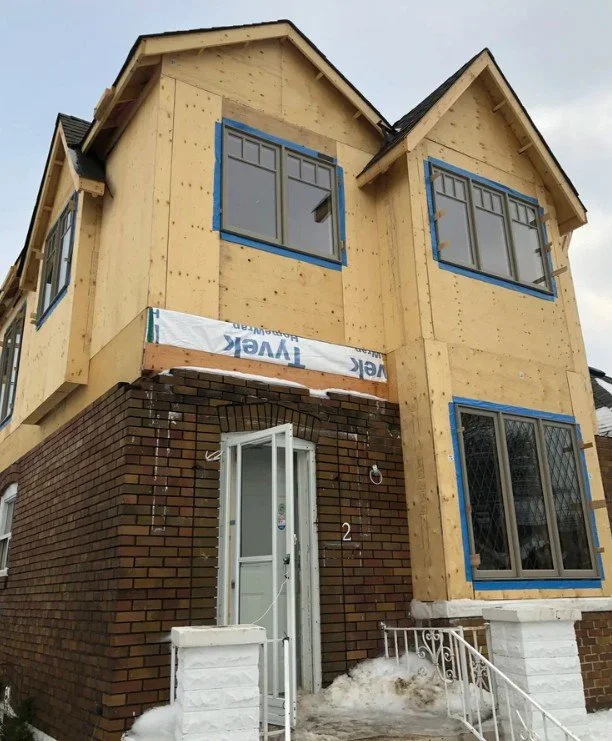

  • His Childhood Home, Reimagined: How BVM Contracting Transformed a 90s Scarborough Interior Into a Masterpiece

    His Childhood Home, Reimagined: How BVM Contracting Transformed a 90s Scarborough Interior Into a Masterpiece

    When a BVM investor trusted us with the home he grew up in, the stakes were personal — and the result will be extraordinary.

    ⚡ TLDR

    Alan Masters grew up in a 1990s Scarborough home that hadn’t been touched since it was built — compartmentalized rooms, outdated everything, no flow for modern family life. After investing in a BVM Contracting custom home project and watching how we operate up close, he trusted us with his childhood home. The result: a full interior transformation featuring a 20-foot open-concept main floor, ultra-custom kitchen, herringbone hardwood, new stairs and railings, three full bathrooms, a gas fireplace, custom millwork, wainscotting, and all-new windows and doors throughout — a complete reimagining of a home that already meant everything.

    Project Information

    When an Investor Becomes a Client

    Alan Masters wasn’t a stranger to BVM Contracting when he called about his home. He was an investor in our Phyllis Avenue custom home project in Cliffcrest — one of our signature builds — and through that project he spent enough time in our world to understand exactly how we operate. He watched how we handled the budget, how the team communicated, how problems got solved. He saw the finished product.

    So when his father passed away the home felt empty but also ripe with opportunity to turn his childhood home into a legacy for his family.

    This wasn’t just a renovation. Alan’s father had been ill for some time, and Alan had been caring for him in the home. The house hadn’t been significantly updated since it was built in the 1990s, and if Alan and his partner Justine were going to build their life here, it needed to become theirs — while honouring the family history inside those walls. That’s a weight most renovation briefs don’t carry.

    We also run in many of the same circles as Alan, and he is mutual friends with several families whose homes BVM Contracting has built or renovated. He had seen our work firsthand and understood the level of quality we bring to every project. That combination — direct investment experience, recommendations from friends whose homes we’d built, and a deeply personal reason to get it right — made 132 Atlee one of the most meaningful projects we’ve taken on.

    Bottom line: The best clients come from trust built over years, not sales calls. Alan already knew what we could do — and that’s what made this project possible.

    One Steel Beam. An Entirely Different Home.

    Walk into a typical Scarborough home built in the 1990s and you’ll find the same layout: walls everywhere, a small kitchen tucked off to one side, a living room that feels cut off from the rest of the house, a front foyer that leads nowhere interesting. It was functional for its era. It’s not how families live today.

    The centrepiece of our main floor transformation at 132 Atlee was a custom 20-foot W8x24 structural steel beam — engineered and installed to eliminate the load-bearing walls separating the kitchen, dining area, family room, and front foyer. When those walls came down, the entire character of the main floor changed. What had been a series of small, disconnected rooms became one cohesive open-concept space with sightlines from the front door all the way to the back of the house.

    For Alan and Justine, Ryan noted there was a mix of emotions when construction began — the excitement of transformation alongside the nostalgia of watching the home they knew come apart. That tension is real in every major renovation — we’ve been through it with families in Scarborough, Leaside, and the Beaches. What carries clients through it is clarity about what’s coming on the other side. Our team stayed close throughout the process, making sure Alan and Justine could always see where the project was headed — because the answer, in this case, was genuinely extraordinary.

    The new main floor is designed around a custom kitchen built by Jim Popoff’s team: the undisputed focal point of the space. Paired with herringbone hardwood flooring throughout, JennAir appliances, a new gas fireplace replacing the old wood-burning unit in the living room, and tile in the front foyer that will anchor the entry — the main level will be something people talk about when they walk through the door.

    Bottom line: One structural decision — the right steel beam in the right place — unlocked the potential of the entire main floor. That’s the kind of pre-construction thinking that separates a renovation that looks good from one that actually works.

    Permit Issues, Phone Calls, And Decisive Action

    Before a single wall came down, the team needed three permits from the City of Toronto: a building permit, a plumbing permit, and a drainage permit. What should have been a routine process ran into a real-world complication (as they usually do with The City of Toronto) and the permit applications stalled.

    At the same time, Alan was out of the country on a trip.

    The typical approach — email chains, document portals, formal correspondence — wasn’t going to work. Alan is a phone call guy, and our team adapted immediately. We shifted to direct phone communication, walked Alan through exactly what the City needed and why, and helped him understand the documentation required to clear the issue on his end. Once Alan submitted the necessary paperwork, the permits cleared — all three arrived on the same day, March 25, 2026.

    Permits for a project of this scope (building, plumbing, drainage) covering structural work, fireplace conversion, and bathroom renovations require coordination with the City of Toronto’s Scarborough building department, a qualified architectural design team (Managed by BVM and The Constructible Design Co.), and responsive communication with the client. The title complication added a layer of complexity that required patience and clear guidance — and our team delivered both.

    Bottom line: Permit complications are not unusual. What matters is how quickly your team recognizes the issue, adjusts the plan, and keeps the project moving — without dropping the client in the process.

    Protecting the Budget Without Cutting the Vision

    One of the more instructive moments on this project came early, when Alan mentioned he wanted to add an EV charger to the garage. The issue: his existing electrical panel was 100 amps — inadequate to support an EV charger properly, and the logical answer was a full service upgrade to 200 amps.

    Our team got pricing from Toronto Hydro for the upgrade. The number came back too high for Alan to justify at this stage of the project. Rather than leave the EV charger conversation as a dead end, we proposed a smarter phased approach: install a separate 100-amp subpanel in the garage now, which handles any garage needs — EV charger, heater, workshop equipment — and leaves the infrastructure in place for a clean 200-amp upgrade whenever Alan is ready to invest in it. No permanent compromise. No sunk cost. A real solution that protected his budget without closing off the future.

    This is the kind of decision-making that separates a builder who understands construction from one who understands clients. The goal isn’t just to execute the scope — it’s to help clients make decisions that serve them well over time.

    Ryan also highlighted a broader lesson from this project about the planning and design phase: Alan invested the time to make selections himself — tile, appliances, kitchen details, paint colours — because he’s retired and could dedicate the hours required. For families with full-time jobs and kids at home, that kind of sustained decision-making is genuinely difficult. Our team consistently recommends working with an interior designer as a strategic investment, not an optional luxury. The clients who treat design and planning as a cost tend to have harder renovation experiences. The ones who invest in it properly get better results — and fewer regrets.

    Bottom line: Smart budget management isn’t about finding the cheapest option — it’s about finding the right option for where the client is today and where they want to be tomorrow.

    The Finishes That Will Make This Home Distinctly Theirs

    The full picture of 132 Atlee Avenue isn’t just a structural story — it’s a design story. Every major finish decision was made with intention, and the combination is what will make this home feel like Alan and Justine’s from the moment you step through the front door.

    The custom kitchen by Jim Popoff is the centrepiece: designed for serious cooking and real entertaining, with the full JennAir appliance package making it functional at the highest level. The herringbone hardwood floors throughout the main level add warmth and a design-forward detail that elevates the space beyond standard renovation territory. New stairs and railings connect the main and second floors as part of the visual identity of the home. Foyer tile anchors the entry and sets the tone before guests reach the living space.

    In the living room, the gas fireplace — replacing the original wood-burning unit — transforms the room into a year-round gathering space with none of the maintenance burden. Custom millwork and wainscotting bring depth and detail to the walls. And one of the most impactful decisions on the entire project: all-new windows and doors throughout the main and second floors, spray-foamed and re-drywalled as part of a full exterior envelope upgrade. The effect on curb appeal was immediate and dramatic — and the energy performance improvement will benefit Alan and Justine for decades.

    Three full bathrooms round out the scope, each refreshed as part of the second-floor transformation.

    Ryan’s prediction: when this home is photographed, the front foyer and the kitchen are going to stop people mid-scroll. We’re inclined to agree.

    Bottom line: When the right finishes are layered together — structural, design, and envelope all aligned — the result isn’t just a renovated house. It’s a home that reflects the people living in it.

    Before & After

    Before: A 1990s interior untouched for 30+ years — compartmentalized main floor, outdated kitchen, wood-burning fireplace, original windows and doors, no connection between living spaces.

    After: Full-interior transformation — open-concept main level anchored by a 20-foot steel beam, ultra-custom kitchen with JennAir appliances, herringbone hardwood floors, refinished stairs and railings, gas fireplace, three renovated bathrooms, custom millwork, wainscotting, all-new windows and doors, full exterior envelope upgrade. A home that honours the family history it carries — and is built for the life Alan and Justine will live in it for decades to come.

    Ready to Start Planning Your Renovation?

    132 Atlee started as a 1990s house that hadn’t changed in three decades. What it became — open-concept main floor, custom kitchen, full exterior envelope upgrade, three renovated bathrooms, work done right — is what happens when the planning phase isn’t rushed and the budget decisions are made with the client’s long-term interest in mind.

    If you’re sitting on a renovation in Scarborough, East Toronto, or elsewhere in the GTA and want an honest conversation about what it would actually take, book a free 20-minute call with our team.

  • The Real Reason Your Contractor Won’t Give You a Price — And Why That Should Terrify You

    The Real Reason Your Contractor Won’t Give You a Price — And Why That Should Terrify You

    TLDR: Most Toronto homeowners start their renovation or custom home project without a firm price locked in — and they pay for it. Literally. BVM Contracting’s upfront pricing process, built on a database of hundreds of GTA projects, means you know the real number before a single nail is driven.

    The Problem Starts Before a Shovel Hits the Ground

    Here’s something we see almost every week: a homeowner calls us with full architectural plans in hand, ready to build. Excited. Optimistic. They’ve spent months with their designer, their plans are beautiful — and then we ask one simple question:

    “Has anyone given you any costing guidance up until this point?”

    Nine times out of ten, the answer is no.

    That’s the moment everything gets complicated.

    In 2026 alone, we’ve received over 15 inquiries from homeowners who were already deep into the design process with zero budget reality check. These aren’t people who were careless — they were doing what everyone told them to do: get the design right, then figure out the cost. But here’s the truth: by the time you have permit-ready drawings and a wishlist-full plan, you may be looking at a number that’s nowhere near your budget — and now you’re emotionally invested.

    The companies designing your project don’t get paid based on whether it gets built. They get paid to design. So when you ask for a double island, a glass staircase, and underfloor heating in every room, they say yes — because why wouldn’t they? Nobody’s having the hard conversation about what it actually costs.

    We end up having that conversation a lot. And yes, we’re often the ones telling a homeowner that their permit-ready plans are $150,000 to $200,000 over what they can actually spend. It’s not a comfortable call to make. But it’s a better call than having it six weeks into construction when the foundation is already poured and the change orders are already flying.

    The Ballpark Estimate Trap

    Two misconceptions come up constantly when we talk to Toronto homeowners about contractor estimates.

    The first: that a ballpark number is roughly as accurate as a detailed scope of work. It’s not. Not even close. A ballpark is a guess. A fully procured estimate — broken down activity by activity, with real quotes from the actual subcontractors and vendors who will do the work — is a number you can actually build a project around.

    The second: that any contractor is doing real procurement when they hand you an early “estimate.” They’re not. No builder worth their weight is going to spend the time sending your plans to their subs and suppliers — and asking those subs to spend their time pricing it — on a project that hasn’t committed to working with them. That’s not how this industry works. What you’re getting at that stage is a gut feel, often based on cost-per-square-foot averages that have nothing to do with your specific project.

    There’s a massive difference between bottom-up estimation — where every line item is priced from actual supplier and subcontractor quotes — and the vague cost-per-square-foot guesses most contractors throw out. Always know which one you’re getting.

    What “We’ll Figure It Out As We Go” Actually Costs

    We’re not going to pretend we’ve always done this perfectly. Early on, we ran projects the way a lot of builders do: start with a rough number, discover costs as you go, manage it as best you can. Sometimes it worked fine.

    Sometimes it was a nightmare.

    Those experiences are exactly why we changed how we work. Today, we don’t start construction until the project is properly planned and fully procured. We use construction management software that forces discipline at every stage — and frankly, when a homeowner pushes back on doing the upfront work, that’s a red flag for us. The clients who resist detailed planning before construction almost always create problems during construction.

    The best outcomes — the projects that finish on time, on budget, with happy clients — come from proper planning. Every single time.

    What Most Homeowners Get Wrong About Construction Budgets

    Here’s where it gets real.

    When you sign a construction contract without a fully procured budget, you’re not just accepting some uncertainty. You’re accepting:

    • Inevitable change orders — those line items that weren’t in the original scope because nobody checked

    • Budget blowouts — costs that “couldn’t have been anticipated” that somehow always show up mid-project

    • Expectation gaps — the difference between what you thought you were getting and what actually gets delivered

    • A poorly executed project — because rushed procurement always means rushed execution

    These aren’t random. They’re predictable. And they’re avoidable.

    Every week someone shares a horror story about a renovation that went 30% or 40% over budget. Every time we hear that story, we know exactly where it went wrong: not enough planning before the first shovel hit the ground.

    There’s also the emotional side of this. There is always stress with residential construction — whoever tells you otherwise is a liar. You can never reduce that to zero. But with proper planning and a fully procured budget (including finishes), the stress gets dramatically reduced during construction. All of the decisions you would have had to make on the fly have already been discussed and decided upon. Yes, there are pivots that have to be made — but they’re a lot less stressful when you’re not also dealing with a dozen other open questions at the same time.

    Clients tell us this every time: when things are properly planned before construction starts, the project feels smooth. It takes more time upfront. It is absolutely worth it.

    The BVM Approach: Know the Number Before You Sign Anything

    At BVM, our upfront construction pricing in Toronto is built on something most builders don’t have: actual data. We’ve built and renovated hundreds of substantial projects across Toronto — custom homes in Leaside, Riverdale, and the Beaches, major additions in East York and Scarborough, full gut renos in Cabbagetown and Leslieville — and we’ve tracked the costs across all of them. That gives us a database that lets us set realistic expectations with you — often before you’ve even committed to working with us.

    Our pre-construction process is multi-disciplinary. That means architects, engineers, designers, and our build team working together from the start — not in silos where one group designs something and another group gets stuck delivering the bad news. We are in your corner throughout the planning process, making sure you’re building something that can actually be built within your budget, and pivoting when needed to keep things on track.

    Here’s the question we want every homeowner to ask any contractor they’re interviewing:

    “Walk me through your process to ensure you’re arriving at a fully procured budget before we sign a construction contract.”

    If they can’t answer that question confidently and specifically — walk away.

    You want a builder who values process. Who builds transparency into every stage. Who won’t lock you into a contract before you know exactly what it’s going to cost. That’s what our pre-construction process is designed to do: give you the confidence that you can build what you want within your budget, or give you the information you need before you’re too invested in something you can’t afford.

    Key Takeaways

    • A ballpark estimate and a fully procured budget are not the same thing — not even close

    • Design firms have zero financial incentive to manage your budget; your builder does

    • Change orders and budget blowouts are almost always predictable and preventable

    • Bottom-up estimation (line item by line item) is the only honest way to price a project

    • If a contractor can’t explain their pre-construction procurement process, keep looking

    • Proper planning takes more time upfront — and it’s the single biggest factor in whether your project succeeds

    Frequently Asked Questions

    Q: How early in the process should I be getting pricing from a builder?

    A: As early as possible — ideally before you finalize your design. If you bring a builder in while you’re still in the design phase, they can flag cost implications in real time and help you make decisions that keep your project buildable and on budget. Waiting until you have permit-ready drawings means you’ve already spent months designing something that may need to be completely reconceived.

    Q: What’s the difference between a fixed-price contract and a cost-plus contract?

    A: A fixed-price contract means your builder has fully procured the project and is giving you a locked number. A cost-plus contract passes the risk of cost overruns to you — you pay whatever it costs, plus a margin. Neither model is inherently wrong, but if you go cost-plus, make sure your builder has done thorough upfront procurement. Otherwise you’re flying blind with your own money.

    Q: Why do some contractors give low estimates early and then charge more later?

    A: Sometimes it’s intentional — a low number to win the job. More often, it’s just a rough guess that was never meant to be accurate. Either way, you absorb the difference. The solution is to never move forward without a detailed, line-item scope of work agreed upon before you sign anything.

    Ready to Talk About Your Project?

    If you’re planning a renovation, home addition, or custom home build in Toronto or the GTA, let’s have an honest conversation before you go too far down the planning path. We’ll give you a realistic read on what your project is actually going to cost — before you’re emotionally or financially committed. No ballparks. No vague cost-per-square-foot guesses. Just honest upfront construction pricing from a team that’s seen everything Toronto’s market can throw at a project.

    Book a call with our team at bvmcontracting.com

  • Home Builder Warranties in Toronto: What to Ask Before You Sign

    Home Builder Warranties in Toronto: What to Ask Before You Sign

    Home Builder Warranties in Toronto: Forget Price — Ask This Instead

    TLDR: Every contractor in the GTA claims to offer a warranty. Very few actually honor it when the time comes. Here’s why the way a contractor handles warranty issues tells you more about their true value than any quote, portfolio, or reference ever could — and the one question you should ask before signing anything.

    Key Takeaways

    • A contractor warranty means nothing without consistent, timely execution — ask for proof, not promises

    • Evaluate builders on their worst-case performance, not their best-case portfolio

    • BVM’s 2-year warranty covers all labour and workmanship, but our commitment to clients extends well beyond any document

    • The Leslieville project: we took full ownership of a plumbing issue that wasn’t ours — and resolved it when 10 other professionals couldn’t

    • Before you sign: ask every contractor for a reference from a warranty or problem situation, not just a completed project

    Every Home Builder Has a Warranty. Very Few Actually Honour Them.

    Here’s something most people don’t realize before they sign a contract: having a warranty and honouring a warranty are two completely different things.

    In Ontario, the industry standard is a 2-year warranty on labour and workmanship. Nearly every contractor in the GTA will tell you they offer one. What they won’t tell you is what happens when you actually try to use it.

    We’ve seen the pattern too many times. A homeowner calls their builder about an issue. The builder goes quiet. Emails get dodged. Visits get rescheduled into oblivion. And eventually, the homeowner hires someone else to fix what should have been covered — and pays for it all over again.

    At BVM Contracting, our warranty document isn’t the differentiator. Our execution of it is.

    What BVM’s Warranty Actually Covers — And What Goes Beyond It

    Our standard warranty is 2 years on all labour and workmanship across every aspect of the project we touched. That’s in line with industry standards.

    But here’s where things get different.

    We’re a family company. That sounds like a tagline — we know. But it actually shapes every decision we make on the job and after it. We treat our clients like family. And family doesn’t get the runaround when something goes wrong.

    We’ve gone well past our 2-year warranty window to help clients who needed us. Not because we were legally obligated to. Because it was the right thing to do, and because we’re proud of the work we put our name on. We’ve even gone out of our way to help with problems that had nothing to do with our work.

    Our recent Leslieville home renovation project is a perfect example. We’d wrapped up a full renovation for their main floor and moved on to the next project. Months later, the clients started dealing with a persistent sewer gas smell. They brought in over 10 different plumbers. Nobody could pin it down. Eventually, they came back to us — not because the issue was ours to solve, but because they trusted us.

    We could have said “that’s not our problem.” Instead, we made it our problem. We brought in our plumber, diagnosed it properly, and resolved the issue at a fraction of what those other plumbers would had cost — with zero displacement of their basement apartment tenant in the process.

    That’s not written into any warranty document. That’s just who we are.

    You’re Evaluating the Wrong Projects

    Most homeowners walk into contractor meetings looking for the highlight reel. Stunning before-and-after photos. Glowing references from the dream clients. The $2M custom build that wrapped on time and on budget.

    That’s exactly the wrong approach.

    No builder is batting 1000. Problems come up on every job — material delays, unforeseen structural conditions, subcontractor issues, weather, supply chain gaps. The question isn’t whether your builder has had problems. It’s how they handled them when they did.

    Ask the hard questions. Ask for references from projects that didn’t go smoothly. Ask a builder to walk you through a job where something went wrong and explain specifically what they did about it.

    Most contractors will pivot, get vague, or promise to follow up and never do. A contractor who answers that question clearly and confidently — who can point you directly to a client who experienced a warranty issue and came out of it satisfied — is showing you exactly what kind of partner they’ll be when your project hits a rough patch.

    That’s the real evaluation. Not the best case. The worst case.

    What Most Homeowners Get Wrong About Contractor “Value”

    When homeowners come to us and say “your quote is the highest — why should we pay more?”, we don’t flinch.

    Our pricing is accurate. That’s the answer.

    We know exactly what it costs to run a professional home building operation — the skilled manpower, the expertise, the project management systems, the long-term relationships with quality subtrades who actually show up when we call. Our margins aren’t padded for profit games. They’re built to support our past clients, our current clients, and our future clients.

    When a contractor’s quote is suspiciously low, you’re usually looking at one of three things: an inexperienced team that doesn’t know their real costs yet, a company planning to cut corners to stay within the number they quoted, or a business that won’t be around — financially or professionally — to honor a warranty two years down the road.

    The contractors who underquote to win work aren’t necessarily bad people. But they often can’t afford to show up for warranty items. Because showing up costs time and money, and if the margins weren’t built correctly from day one, neither is the capacity to do right by you later.

    The Biggest Warranty Failure We’ve Ever Cleaned Up

    We’ve repaired a lot of other contractors’ work over the years. Too many jobs to count.

    But one stands out.

    We were called in to assess a foundation wall on a Toronto property. What we found was genuinely alarming: an exterior foundation wall constructed with CMU block — no mortar. Just stacked CMU block.

    A structural repair. Significant cost. A homeowner left holding the bill because someone either didn’t know what they were doing or cut corners so aggressively that basic structural integrity got sacrificed somewhere along the way.

    That’s the extreme end of the spectrum. But whether it’s a mortar-free foundation or a sewer problem that 10 plumbers couldn’t diagnose, the common thread is a builder who wasn’t there when it mattered most.

    Warranty work is inevitable. That’s not pessimism — it’s just construction reality. The question you need answered before you sign anything is: when that time comes, will your builder actually show up?

    What Most Homeowners Get Wrong About Contractor Warranty

    The mistake we see constantly: homeowners ask for references, get the highlight reel, and think they’ve done their due diligence.

    Here’s the shift that changes everything.

    Tell every contractor you’re evaluating: “Can you give me a reference from a client who experienced a problem during or after their project — and can you tell me what you did about it?”

    Watch what happens.

    Some will get uncomfortable. Some will pivot to their best project stories. Some will genuinely not have the answer ready.

    And some — the ones worth working with — will have that answer immediately. Because they’re proud of how they handled it. Because client care isn’t a policy for them; it’s a reflex.

    That single question reveals more about a builder than five portfolios, three testimonials, and a polished sales deck ever could.

    The BVM Approach to Warranty Work

    Here’s how we operate when warranty items come up:

    We respond. When a client reaches out about an issue, we’re not dodging calls or letting emails pile up.

    We show up. Even when an issue isn’t technically within our scope, we assess it, stay involved, and help find the most cost-effective path forward.

    We go beyond the expiry. Our 2-year window is a legal standard. Our commitment to our clients isn’t.

    We own the problem. If it’s our work, it’s our responsibility — period. We don’t play the blame game or pass homeowners around between subtrades. We take ownership and we solve it.

    That’s what “standing behind your work” actually looks like in practice. Not a clause in a contract. A track record.

    Frequently Asked Questions

    Q: How long is BVM Contracting’s warranty?

    A: Our standard warranty is 2 years on all labour and workmanship for every aspect of the project we completed. In practice, we support our clients well beyond that window. If something comes up and we can help, we do.

    Q: What should I ask a Home Builder about their warranty before signing a contract?

    A: Ask them specifically for references from clients who experienced a warranty or workmanship issue. Ask them to walk you through a project that hit a problem and explain what they did about it. How confident and detailed their answer is will tell you everything about the kind of partner they’ll be.

    Q: Why does BVM sometimes quote higher than other Home Builders?

    A: Because our numbers are accurate. Our pricing reflects the real cost of running a professional operation — the staff, expertise, and systems that allow us to deliver great work and stand behind it. A lower quote often means something gets cut somewhere, and that cut typically shows up at warranty time.

    Q: Is it normal for construction projects to experience issues?

    A: Completely normal. No builder has a perfect record across every project. What separates great builders from average ones is how quickly and completely they respond when issues arise. Don’t evaluate a contractor by whether problems have ever occurred — evaluate them by how they handled it when they did.

    Ready to Talk About Your Project?

    If you’re evaluating contractors for a renovation or custom home build in Toronto, we’d welcome the real conversation — including the uncomfortable questions. We’ll give you references from the highlight reel and from the jobs that got messy, because we’re proud of how we showed up in both.

    Book a call with our team directly at bvmcontracting.com. Let’s talk about your project, your concerns, and what a builder who actually stands behind their work looks like in practice.

  • A Home Addition Avoided With Thoughtful Planning

    A Home Addition Avoided With Thoughtful Planning

    How a Growing Upper Beach family skipped the addition — and got exactly what they needed inside the walls they already owned

    ⚡ TLDR

    Daniel and Liz came to BVM Contracting wanting to add a third bedroom before their newborn arrived. When our team discovered that 79 Kimberley was already sitting at approximately 69% site coverage — with no room to build out under current zoning — we could have told them to file for a Committee of Adjustment hearing and wait 12 to 18 months for an answer. Instead, we found the bedroom they needed inside the space they already had. No addition. No committee hearings. No delays. Construction started May 1, 2026, exactly as planned.

    That’s the difference between a builder who sells scopes and one who solves problems.

    Home Renovation Project Information

    Project Type: Second-floor interior reconfiguration + full bathroom renovation + exterior cladding refresh

    Location: The Upper Beaches, East Toronto

    Scope: New third bedroom carved from existing second-floor space; complete bathroom renovation; primary bedroom layout redesign; laundry relocation to stacked unit; Kaycan white lap siding replacement + black window installation

    Duration of Construction: Spring – Summer 2026 (in progress)

    Timeline of our services: Pre-construction through to construction

    Clients: Young growing family, The Beach

    Architectal Partner: Mark Smith — markhsmith.ca

    Project Cost: Inquire here

    Before and After

    To be added once the project is completed.

    The Addition That Couldn’t Happen — And the Solution That Could

    Daniel and Liz reached out to BVM Contracting in September 2025 with a clear goal: they needed a third bedroom before their baby arrived. Their home at 79 Kimberley in The Beach was already the right house in the right neighbourhood — they just needed it to grow with them. They came in assuming the answer was a side cantilever or a small addition.

    Our team ran the FSI and density numbers alongside architectural partner Mark Smith. The result was unambiguous: 79 Kimberley was already at approximately 69% site coverage under Toronto’s zoning rules. Any addition — no matter how modest — would have triggered a mandatory Committee of Adjustment hearing. That process adds between 4-6 months to a project planning timeline and delivers no guaranteed outcome at the end of it. With a newborn on the way in March 2026 and a May 2026 construction start locked in as the target, that path simply didn’t work for this family.

    So we pivoted. And we did it fast.

    Working through the existing second-floor footprint with Mark Smith, our team identified an opportunity that a less experienced eye would have missed: the space beneath the mezzanine and the existing laundry room could be reconfigured to produce a fully functioning third bedroom — complete with a stacked laundry unit relocated to the adjacent space, a completely redesigned bathroom, and a reimagined primary bedroom layout. All of it inside the existing building envelope. Not a square foot added to the outside. And the clients were genuinely relieved — not disappointed — when the reconfiguration plan came together. They were keeping the project on track, keeping their timeline, and getting exactly the outcome they needed.

    Bottom line: When a zoning path is closed, a good builder finds another door — and opens it faster than anyone expected.

    PHOTOS TO BE ADDED HERE

    No Surprises in Demo — Because We Asked the Right Questions First

    Older Toronto homes carry history in their walls. 79 Kimberley was no exception. The pre-demo conditions included a decommissioned Jacuzzi with its own electrical subpanel and dedicated drain, an unused gas fireplace line, drainage roughed into the mezzanine, and a digital bath controller that hadn’t seen active use in years. In the wrong hands, that’s a list that becomes an extras invoice — delivered to a client who didn’t see it coming.

    That’s not how BVM operates.

    During the pre-construction planning process, our team worked directly with Liz and Dan to document every known condition in the home before a single wall came down. The Jacuzzi panel, the gas line, the mezzanine drainage, the old bath controller — every item was identified, walked through, and included in the scope of work before we signed a contract. No surprises. No add-ons tied to conditions we already knew existed.

    This is a pattern in the industry that frustrates homeowners, and rightly so: some contractors treat pre-existing conditions as “unknowns” because it’s easier to add them to the bill mid-project than to do the homework upfront. Our approach is the opposite. If it’s going to need to be dealt with, it gets priced before we start — because that’s what honest contracting looks like.

    Bottom line: Pre-construction due diligence isn’t overhead — it’s the reason your renovation doesn’t come with a surprise invoice halfway through demo.

    Four Proposals, One Right Answer

    Getting the layout right for 79 Kimberley wasn’t a straight line. It never is when you’re reconfiguring a second floor that needs to simultaneously create a new bedroom, improve the primary bedroom, relocate laundry, and fully renovate a bathroom — all without adding space. Our team and Mark Smith worked through four distinct design proposals before landing on Option 2A: the configuration that solved for everything the family needed without compromising the rest of the home.

    The pivotal decision in Option 2A was the laundry. Relocating the washer and dryer off the main second-floor circulation and stacking them in a purpose-built alcove near the new bedroom and bathroom freed up the primary bedroom completely. Bedroom 1 could be fully redesigned — better flow, more usable square footage within the same walls, a layout that felt intentional rather than inherited. Because Liz and Dan had underused space in the mezzanine level, the stacked unit fit without eating into any liveable area they were actually using.

    The second floor that came out of Option 2A works like a proper family home: three bedrooms, a completely renovated bathroom, laundry that’s accessible but not in the way, and a primary bedroom that feels like it was designed for the family living there — not retrofitted around whatever the original plan had allowed.

    Four rounds of proposals isn’t a sign of indecision. It’s the design process doing exactly what it’s supposed to do.

    Bottom line: The right layout takes iteration. The clients who commit to working through the options always end up with a home that works better.

     Layout of existing second floor before layout change to add the third bedroom
    Layout of existing second floor before layout change to add the third bedroom
     Proposed layout for the second level at 79 Kimberley Avenue, which features an adjusted bathroom and new 3rd level bedroom
    Proposed layout for the second level at 79 Kimberley Avenue, which features an adjusted bathroom and new 3rd level bedroom

    Building Around a Baby — And Getting the Timing Right

    When Dan and Liz signed with BVM, their baby was due in March 2026 — right in the middle of what would become a critical stretch for design finalization and permit approval. Building and plumbing permits were issued in January 2026. That left roughly two months to lock all pre-construction details before a newborn arrived and the pace of every decision in the household changed.

    Our team didn’t wait to see how that played out.

    Subcontractors were brought to site earlier than the standard schedule required so they could assess the scope firsthand. The full scope of work was documented and finalized before the baby arrived. When Daniel and Liz needed time to focus on their new family — and they absolutely got it — the project file was already in a ready state. Once the new parents found their footing, construction started on schedule: May 1, 2026, exactly when we’d planned.

    That’s what proactive project management looks like in practice. Not chasing clients for decisions at the last minute. Getting ahead of the timeline so the client doesn’t have to choose between their family and their renovation.

    Bottom line: A construction timeline can’t stop for life — but a good builder plans so that life doesn’t have to stop for construction either.

    The Exterior Refresh: White Siding, Black Windows, and a Reason to Come Home

    The scope at 79 Kimberley isn’t limited to what’s happening inside. The original painted exterior siding was due for a full replacement, and Daniel and Liz had a specific vision for the front of the house: clean, bright, and modern — a facade that would match the refreshed home behind it.

    After reviewing options, the final exterior spec landed on Kaycan white lap siding replacing the existing boards, with new black-framed windows being installed in the same sequence. It’s a combination that works in this neighbourhood: the bright white field against bold black windows reads as updated and intentional without chasing trends that won’t age well. The contrast is clean. The result is a front elevation that earns a second look.

    Getting that exterior work done came with a coordination layer most Toronto renovations don’t involve: a Toronto Hydro service isolation. Where utility lines run close to the siding and window work area, the installation can’t proceed until the line is temporarily taken down. Our team initiated that process proactively — filed the isolation request with Toronto Hydro, coordinated the signed submission with Liz, and is now sequencing the siding and window installations to happen in a single mobilization once the isolation date is confirmed. One coordinated effort, not a multi-stage scramble that adds time and cost.

    Bottom line: When city utilities are part of the construction puzzle, the answer is to get ahead of the coordination — not react to it after it holds up your schedule.

    What This Project Is Really About

    Beyond the permit numbers, the layout options, and the square footage math, 79 Kimberley comes down to something simple: a family choosing to stay in the community they love.

    Daniel and Liz didn’t want to upsize, sell, and start over somewhere else. They wanted to make the home they had work for the family they were building. The Beach is where they want to raise their children. This renovation — a third bedroom, a better bathroom, a fresh exterior — is what makes that possible.

    We’re not in the business of selling the most expensive project on the table. We’re in the business of finding the right solution. Sometimes that’s a full custom build. Sometimes it’s understanding that the space your clients need is already there — it just needs someone willing to find it.

    Ready to Find Out What Your Home Can Become?

    The 79 Kimberley project proves that the right answer isn’t always the obvious one. Before you commit to an addition — or assume your current home can’t accommodate your family’s next chapter — talk to our team. We’ll run the FSI numbers, walk your space, and tell you honestly what’s achievable and what the fastest path to it looks like.

  • Two Years of Planning. A Forever Home Worth Every Day of It.

    Two Years of Planning. A Forever Home Worth Every Day of It.

    The Cliffcrest Drive Custom Home Build

    How a meticulous Scarborough couple evaluated every option, visited the evidence, and built the most thoughtfully planned custom home we’ve ever taken on.

    TLDR

    Rafal and Oksana came to BVM Contracting in February 2023 with a property in Cliffside (located in the Scarborough Bluffs), three possible directions forward, and more detailed questions than most builders ever get asked. After two-plus years of pre-construction planning, two reference home visits, a Committee of Adjustment process, an OBC Package A2 insulation upgrade, a dual-zone HVAC system, and a legal basement apartment added to the program, they’re breaking ground in August 2026 on a ~5,100 sq ft forever home in Scarborough’s Cliffside neighbourhood, budgeted at approximately $1.85M. When the planning is this thorough, the build almost takes care of itself.

    Home Build Project Information

    Project Type: Full tear-down and custom new home build

    Location: Cliffside, Scarborough, Toronto

    Scope: ~3,800 sq ft above grade (inclusive of garage) + ~1,300 sq ft basement (legal apartment + mechanical/gym/wine cellar) — ~5,100 sq ft total

    Pre-Construction Timeline: February 2023 – present (2+ years of planning and design)

    Construction Start: Target August 2026

    Clients: Rafal & Oksana

    Architectural Designer: David Smith

    Project Budget: ~$1.85M

    Three Options, One Right Answer

    When Rafal and Oksana first came to BVM in early 2023, they weren’t arriving with a blank cheque and a simple ask. They had a property in Cliffside, a vision for how they wanted to live, and three legitimate paths forward: a home addition, a second-storey top-up, or a full tear-down and new build.

    Our team worked through each option with them honestly. What became clear quickly was this: a new build wasn’t just the best option — it was the only one that actually matched what they were trying to achieve. They wanted to start fresh and create a layout that worked for their family without the constraints of working around an existing structure. They also wanted to incorporate a legal basement apartment — a space to house relatives now, and eventually generate rental income when the time was right. An addition or a top-up would have cost a similar amount of money while still requiring them to work within the limitations of a foundation and layout that were never designed for their life.

    The new build route won not because it was the most expensive option, but because spending a very similar amount of money and still being locked into someone else’s decisions wasn’t a trade-off worth making.

    Bottom line: When the cost of the right solution and the wrong solution are close, you build right.

    They Didn’t Just Ask Questions. They Visited the Evidence.

    Before Rafal and Oksana committed to anything, they asked to see our work. So we arranged two site visits and the two couldn’t have been more different.

    The first was 87 Lorraine Drive, a BVM new build still in its finishing stages. Most prospective clients only ever see a completed, staged home. Rafal and Oksana walked through while work was still underway, which meant they could see the behind-the-scenes areas. An unfinished basement, the mechanical rough-ins, what’s inside the walls before they close. They weren’t aligned with that home’s overall design direction or finish level, but that wasn’t the point. They came to see the quality of construction, and they asked the questions that mattered to their project: sewage ejector, in-floor heating, HVAC configuration, flooring, windows.

    The second visit was the one that sealed it. We asked our clients at 396 Rouge Highlands Drive, a BVM home three years after completion, fully lived-in — if they’d open their home to a family they’d never met. They didn’t hesitate. For Rafal and Oksana, it was an entirely different experience: a finished home, real people living in it, and a candid conversation about what working with BVM was actually like. When they walked out of that visit, they’d heard directly from homeowners who had nothing to gain from saying something kind and said it anyway.

    What happened between Rafal and Oksana and our past clients, we actually heard about after the fact. But what we heard confirmed everything: that was the visit that removed the last remaining doubt. That kind of organic trust, built without any coaching from us, is the clearest measure of success we know.

    Bottom line: The best sales tool we have is a client who’s proud enough to open their front door.

    Two Years of Pre-Construction: Here’s What That Actually Looks Like

    For a project this complex, pre-construction isn’t a waiting room between signing and breaking ground. It’s where the build is won or lost.

    Our team worked through what we call “sprints” with Rafal and Oksana, intensive periods of several weeks where significant ground got covered: budget build-outs, design reviews, scope adjustments, engineering consultations. These were followed by quieter stretches while the clients worked through their own decisions, navigated the Committee of Adjustment process, and sorted out financing. Keeping momentum through those quieter periods took effort. We made a point of checking in regularly, not with status updates for their own sake, but with high-value touchpoints: site visits, budget comparisons, scope conversations that actually moved the needle.

    We also transitioned to new project management software during this period and migrated Rafal and Oksana’s full budget into the new system. There was a learning curve (there always is) but the outcome for them is unmatched transparency and real-time visibility into every line of the project. They can see exactly where their money is going, when it’s going, and what’s coming next. For clients this detail-oriented, that level of access isn’t a nice-to-have. It’s the baseline they expect.

    Two years of pre-construction on a project of this scope and ambition is what doing it properly looks like. Every month of deliberate planning translates to fewer surprises when the crew is on site.

    Bottom line: The longer and more thorough the pre-construction process, the smoother (and better) the build.

    The Insulation Decision That Will Pay Off for 30 Years

    Most homeowners never think about insulation compliance packages. Rafal and Oksana did, and they made the right call.

    When the question of insulation strategy came up during the design phase, there were two clear paths under the Ontario Building Code. OBC Package A1 is the baseline: R-22 cavity insulation, simpler to build, lower upfront cost. OBC Package A2 goes further, continuous exterior insulation across the full building envelope, higher performance, more complexity, and in this case, a 12-inch foundation wall required to accommodate the assembly.

    The decision came down to a simple principle: they’re only doing this once. They wanted to invest in a better thermal envelope. They want a home that performs, not just a home that looks good. The added cost was real. The tradeoffs were real. They understood both and chose Package A2 anyway, because the long-term payoff (better energy efficiency, lower operating costs, improved year-round comfort for the life of the building) justified every dollar of the premium.

    This is the kind of decision that never shows up in a listing description or a photo gallery. But it’s exactly the kind of decision that separates a home that performs from one that merely appears to.

    Bottom line: The right insulation strategy isn’t a line item, it’s a 30-year decision.

    “Way Nicer.” The Facade and What’s Inside

    When Oksana built her own facade concept using Google’s Gemini AI. She generated a front elevation that captured the design direction she had in mind and sent it to our team, the response was two words: “Way nicer.”

    That moment captures who these clients are. They don’t wait to be inspired by what’s put in front of them. They bring their own vision and ask us to build it.

    The exterior vision is classic and confident: quality brick complemented by precast limestone accents. It is traditional bones with a modern presence. The couple initially considered using more expensive limestone across the full front elevation. Choosing brick and redirecting those savings into standout precast accents was exactly the right call: more character per dollar spent, and a more durable, lower-maintenance envelope over time.

    Inside, the program reflects the same level of intention. The main floor anchors around a great room with roughly 18-foot ceilings and double-level windows. This is a space that immediately signals this is not a production home. A large kitchen with a servery and pantry, a formal office, a library, and a mudroom-powder room combo at the entry round out the main floor. The second level holds four bedrooms, three full bathrooms, generous closet space, and a centralized laundry room. Below grade, the basement splits between a purpose-built legal apartment and a combination mechanical room, home gym, and wine cellar.

    Bottom line: When every decision is intentional from the start, the finished home doesn’t just look right — it works right for the family living in it.

    What Meticulous Clients Actually Tell You About a Builder

    Rafal and Oksana asked specific, technical questions at every stage. HVAC duct routing. Foundation wall thickness. Window brand comparisons. Insulation R-values and compliance pathways. These aren’t casual conversations — and they’re not meant to be.

    Clients who ask at this level serve an important function: they filter out the builders who aren’t prepared to educate, explain, and engage honestly with the details. The ones who give vague answers, deflect, or talk clients out of asking don’t survive this kind of scrutiny. Our team met every question with a real answer. And there were moments where the most honest thing we could say was: “We don’t have that answer right now, but we’ll find it.” That kind of humility, admitting a gap and committing to close it, is a powerful signal to the right kind of client. It shows a team that cares more about getting it right than appearing to already know everything.

    Rafal and Oksana are the exact type of clients BVM Contracting is built to serve. Their meticulousness is matched by our process. When the client cares deeply about every detail, and the builder has a system built to handle it, the outcome is almost always exceptional.

    Bottom line: The clients who ask the hardest questions tend to get the best homes.

    Coming August 2026: The Home That Was Worth Waiting For

    As of spring 2026, this project is in permit coordination with financing in progress and a firm target of August 2026 to break ground. Procurement is about to begin, locking in subtrades, finalizing budget details, and completing value engineering to find the right places to tighten without compromising what matters.

    When this home is finished there will be an ~18-foot great room overhead, a legal basement apartment ready for family or rental income, a high-performance insulated envelope, a dual-zone HVAC system designed from first principles. Rafal and Oksana are going to feel something most homeowners never fully experience, the satisfaction of knowing every decision was made deliberately, with full information, and with time to get it right.

    Of all the decisions made during this pre-construction process, the one our team is most proud of guiding is the dual HVAC system. They were the ones steering the ship, but our team gave them the information they needed to arrive at the best decision for their specific home and use case. That’s how it should work: we bring the expertise, the clients bring the commitment, and the outcome belongs to both.

    The more planning completed before construction starts, the better the outcome. Two years of evidence proves it.

    Bottom line: The best custom homes aren’t built fast, they’re built right. And right starts years before the foundation is poured.

    Ready to Start Planning Your Custom Build?

    This custom home building project is proof that the pre-construction phase isn’t overhead, it’s the work. The decisions made before a single wall goes up determine whether the finished home matches the vision or falls short of it. For Rafal and Oksana, two years of deliberate planning means no regrets when the dust settles.

    If you’re thinking about a custom new build, tear-down rebuild, or major home addition in Scarborough, the Bluffs, East Toronto, or anywhere in the GTA, our pre-construction process gives you the clarity and confidence to build right

  • The Side Extension That Became a Four-Level Transformation

    The Side Extension That Became a Four-Level Transformation

    A Guildwood Home Addition Story

    They pivoted the plan to save money. Then built everything anyway. Here’s what that decision — and the right contractor — actually delivered.

    ⚡ TLDR

    10 Wooster Wood started as a plan to add a second storey to an existing Guildwood bungalow. When the budget couldn’t support it, the team pivoted to a two-level side extension instead — and Morgan and Nazorio ended up with a four-level home, an attached garage, vaulted ceilings, a complete exterior redesign, and a fully renovated main floor and basement. Total budget: approximately $850,000 including finishes and landscaping. Demo started September 2023. Permit closed 2025. One more thing: BVM Contracting was outbid for this job. Morgan and Nazorio reviewed the other contractor’s contract, came back to us, and the rest is this case study.

    Before & After Home Addition Toronto

      Before photo of our guildwood side extension project. The home now looks like a completely new home now, nearly unrecognizable from it’s past form.
    Before photo of our guildwood side extension project. The home now looks like a completely new home now, nearly unrecognizable from it’s past form.
      The finished exterior of 10 Wooster Wood — stone, longboard siding, stucco, and a custom garage canopy that required engineering revisions mid-construction to get exactly right
    The finished exterior of 10 Wooster Wood — stone, longboard siding, stucco, and a custom garage canopy that required engineering revisions mid-construction to get exactly right

    They Almost Hired Someone Else. Then They Read the Contract.

    Before a single piece of drywall came down at 10 Wooster Wood, this project was headed to a different builder.

    BVM Contracting submitted a proposal for 10 Wooster Wood. So did another company. The other company came in lower. Morgan and Nazorio were prepared to move forward with them — until they sat down with both contracts.

    The competing builder’s contract was written in the builder’s favour. Broad language that allowed extras to be charged with minimal client recourse. Terms that gave the builder significant billing flexibility without meaningful accountability to the homeowner. Morgan Sim is a founding partner at Parker Sim LLP. She knew exactly what she was reading. She and Nazorio came back to BVM.

    Our contract is built to be fair to both parties. It defines what constitutes a change order and what doesn’t. It protects the client’s budget from arbitrary extras. It creates accountability in both directions. That’s not a selling point — it’s the reason this project ended up in our hands, and the foundation that every subsequent decision on this project was built on.

    Bottom line: Before you compare construction quotes, compare the contracts. A lower number tied to an unfair contract will cost you more in the end.

    Before the Walls Came Down, the Surprises Began

    BVM Contracting ordered DSS (Designated Substances Survey) testing before demo kicked off. What came back changed the scope of the demolition phase before a single tool hit drywall.

    Asbestos. In the drywall compound and caulking on the main floor. In the basement. In the air registers throughout the home — eight of them at $200 per register.

    Finding it before demo started is what matters. A contractor who skips pre-demo hazardous materials testing is a contractor who discovers asbestos mid-demolition — stops work, scrambles for abatement quotes, and charges the client for the delay on top of the abatement cost. We found it first, so we could plan properly: certified abatement company brought in immediately, multiple quotes obtained to ensure the clients’ money was being spent as efficiently as possible, and every phase of work staged around the abatement schedule.

    Every discovery was communicated to Morgan and Nazorio immediately — in writing, with pricing attached, before any abatement work was authorized. The basement abatement came in at $3,800 + tax. The eight air registers added $1,600. Each cost was itemized as a formal change order on the project budget — visible, documented, and approved.

    Morgan’s response after the first round of pricing: “Hopefully that is the last of the surprise asbestos. We appreciate you letting us know.”

    That kind of calm, trusting response doesn’t happen by accident. It happens when clients know from day one that bad news won’t be buried — it will be surfaced, priced, and solved.

    Bottom line: Pre-demo hazardous materials testing isn’t optional on older homes — it’s how a responsible builder protects the project schedule and the client’s budget from day-one surprises.

    The Pivot That Expanded the Project

    The original plan for 10 Wooster Wood was a full second-storey addition on top of the existing Guildwood bungalow. More living space, more bedrooms, same footprint. It was a logical concept — until the budget numbers came back and confirmed it wasn’t achievable within the financial parameters the clients had set.

    Going up on an existing bungalow compounds quickly: structural reinforcement of the existing floor system, roof removal, temporary weatherproofing, re-engineering of load paths. The costs add up fast. The budget couldn’t support it at the level Morgan and Nazorio wanted.

    The team proposed a different path: a two-level side extension built beside the home rather than on top of it. The logic was sound — build the new square footage adjacent to the existing structure, keep the construction footprint contained, and in theory limit how much the existing main floor and basement would need to be touched. Phase two could handle those spaces later, if needed.

    That’s not what happened. Once the side extension was confirmed and the clients could see what was possible, the decision was made to do everything: fully renovate the existing main floor, fully renovate the existing basement, and redo the front facade while they were at it. The savings the scope pivot was supposed to generate were reinvested directly back into the project.

    It’s one of the most consistent patterns we see in major renovations. Clients don’t want to live in a half-finished home. They don’t want to come back in three years and do the rest. So they stretch — and do it all at once. It’s a completely rational decision. It just requires honest budget management and clear eyes about the financial commitment involved.

    The result: four separate levels — main floor, two levels of the side extension, basement — plus an attached garage built within the extension footprint. A home that looks nothing like the bungalow it started as.

    Bottom line: Scope decisions made during a renovation aren’t surprises — they’re choices. The right builder makes sure you understand the financial implications of every choice before you make it.

    Vaulted Ceilings, Permit Revisions, and a Kitchen Worth the Wait

    Three features defined how this project got built.

    The vaulted ceilings. Main-level vaulted ceilings were on the wishlist from the beginning. Before the contract was signed, the team confirmed the structural viability. The catch: making it happen required a complete replacement of the existing roof — not a minor cost. Morgan and Nazorio understood the number and made the call. Given that budget expectations had been a point of friction throughout, it was a real win when the revised pricing landed. The finished ceiling transformed the main level — open, light-filled, and architecturally distinct from anything the original bungalow offered.

    The exterior revision. Mid-construction, the exterior design went through a formal revision. The elevation — stone, longboard siding, stucco, and the garage canopy detail — was re-engineered and re-drawn, then submitted for a permit revision. BVM coordinated directly with the architect and the city inspector to keep framing moving while the paperwork was processed. Missing details in the original drawing set — including the garage overhang measurement needed by the framers — were flagged by the BVM team and pushed through on a tight timeline.

    The steel savings. The structural steel scope was repriced during the build. Final cost: approximately $6,800 against an original estimate of $13,500. The $6,700 in savings was credited back to the project budget. Savings don’t come from luck — they come from a builder who’s actively looking for them and passing them through.

    The kitchen was installed in late March 2024 — one of the last major milestones before the project moved toward permit close.

    Bottom line: When a builder is actively managing every line item, savings show up the same way problems do — through attention and follow-through.

    What the Design Process Actually Cost — And the Company We Built Because of It

    One lesson from 10 Wooster Wood applies to every homeowner planning a major renovation: the design process is not a formality. It is the project.

    10 Wooster Wood involved three organizations: BVM Contracting on construction, an architectural designer for permit drawings, and an interior designer for the kitchen. Throughout the project, the BVM team routinely identified gaps in the architectural drawing set — missing measurements, incomplete material specifications, and details that needed resolution before the framers could proceed. Every gap cost coordination time. Every clarification request added friction to the build. The team navigated it, the project got done, but the pattern was consistent: bare-bones design documentation transfers costs from the design phase directly into the construction budget.

    It’s one of the central reasons BVM Contracting created The Constructible Design Co. — our in-house design service built specifically to produce drawings that builders can actually build from. Detailed. Grounded in existing conditions. Field-ready. The kind of documentation that doesn’t require daily phone calls to the architect because the drawings don’t answer basic construction questions.

    If you’re planning a renovation or addition, treat the design process as a strategic investment. A detailed, constructible set of drawings is among the best dollars you can spend before construction begins. The most expensive drawings you’ll ever have are the vague ones you thought were saving you money.

    Bottom line: In projects of this scale, the quality of the design documentation determines how much of your budget survives the construction phase intact.

    Permit Closed. Family Moved Back In.

    The permit for 10 Wooster Wood closed in 2025 — a process that stretched beyond the initial schedule due to a framing inspection that required a structural engineer’s report and review before the city inspector would sign off. It was handled directly, coordinated professionally, and closed without drama.

    Morgan and Nazorio moved back into a completely transformed home. What had been a single-level Guildwood bungalow became a four-level residence with an attached garage, vaulted ceilings, a fully renovated main floor and basement, and an exterior that’s a different building in every visible way.

    This project was big. It was more expensive than the original scope. It took longer to permit-close than planned. Morgan and Nazorio pushed for everything — and got it. The result is a home they won’t need to revisit for a very long time, which is exactly what doing it all at once is supposed to deliver.

    Bottom line: There’s a cost to doing everything at once. There’s also a cost to doing it halfway — and that bill tends to show up at exactly the wrong time.

    Ready to Plan Your Home Extension or Renovation?

    10 Wooster Wood shows what’s possible when a major renovation or side extension is managed with honest budget conversations, proactive communication, and a contractor who treats the client’s investment the same way they’d treat their own. Even when the scope grows, even when surprises show up, even when permit timelines stretch — the right team keeps the project on track.

    If you’re thinking about a home addition, a side extension, or a full renovation in Guildwood, Scarborough, or anywhere in the GTA, let’s talk before you lock in a scope, a budget, or a contractor.

  • How Families Create More Space in Toronto (Without Moving)

    How Families Create More Space in Toronto (Without Moving)

    How BVM Contracting Helps Growing Families Find More Space in Toronto

    TLDR: Moving isn’t the only answer when your family outgrows your home. Toronto families have more options than they think — from basement transformations to second-storey additions to garden suites — and the numbers often favour staying. Here’s how we help families figure out the right move (even if that move isn’t a move).

    Key Takeaways

    • Moving isn’t the only answer when your family needs more space — renovation options are often more affordable than the full cost of moving.

    • The most common space-adding project in Toronto is a second-storey addition, but basement renovations, interior reconfigurations, and garden suites are all viable depending on your situation.

    • There is no accurate cost-per-square-foot calculator for existing home renovations — the real number depends on the existing conditions of your specific home.

    • Toronto’s permit timeline for additions and secondary dwellings runs 6–12 months minimum; interior renovations move through the process significantly faster.

    • Getting a builder involved early in the design process — before you fall in love with plans — saves money and prevents costly surprises.

    The Conversation We Have Almost Every Day

    A family in the Upper Beaches calls us. Two kids, a third on the way, and a house that’s already bursting. They’ve been browsing listings in Ajax, Whitby, maybe Oshawa — places where their money stretches further. They’re ready to leave the neighbourhood they love.

    Before they sign anything, they call us.

    That’s a conversation we have almost daily with families throughout the Greater Toronto Area. And what they usually discover is that moving isn’t their only option — and often isn’t even their best one.

    There is no single solution for maximizing space for a growing family. That’s the honest answer. What we do is listen to what the family actually needs, look at the existing site conditions, understand the budget constraints, and figure out what’s realistically possible. Sometimes that’s a full second-storey addition. Sometimes it’s carving out a bedroom from wasted space. Sometimes it’s a garden suite in the backyard so grandma can live independently close by.

    We’re not in the business of selling a specific product. We’re in the business of finding the right solution. That mindset is what separates us — and it’s what keeps families calling us back, and referring their friends.

    The Real Options for Adding Space in Toronto

    The most common way Toronto families add more space is through a second-storey home addition. But that’s far from the only path, and it’s not always the right one.

    Here’s a breakdown of the approaches we use with our clients:

    Second-Storey Addition

    Adding a full second floor is the highest-impact option. It essentially doubles your home’s footprint. It’s also the most complex and typically the highest investment — and requires a full permit process that can take 6–12 months in Toronto before a shovel hits the ground.

    Rear or Side Extension

    Extending the main floor footprint outward can add a bedroom, family room, or expanded kitchen. Rear extensions are common in East York, Birch Cliff, and the Beaches. Costs depend heavily on the existing structure — what’s already there in terms of insulation, windows, plumbing, and electrical all factor into the real number.

    Basement Renovation

    We’ve transformed underutilized basements into proper living spaces — bedrooms for growing kids, recreation rooms, upgraded laundry — without touching the main floor at all. One of our recent projects in Birch Cliff (Scarborough) did exactly this. The family got functional bedrooms for their children and a great rec room, all by maximizing space that was sitting empty below their feet.

    Basement renovations also have a key advantage: they typically move through the City of Toronto’s permit process significantly faster than additions. Interior renovations are fast-tracked because there are far more of them — the city has a separate, quicker process for them.

    Interior Reconfiguration

    Sometimes the space already exists — it’s just being used wrong. We’re currently working with a family preparing for their second child who came to us thinking they needed a rear extension to add a third bedroom. After reviewing the layout of their existing second floor, we found that their oversized primary suite with a loft space could be reconfigured to carve out a proper third bedroom — no addition required. That saved them a significant amount of money and months of permit delays.

    Garden Suite or Laneway Suite

    These are separate dwelling units built in your backyard. We’ve built garden suites for families where an adult child needed independent living space — freeing up the main house for the parents. It’s an approach that creates real independence while keeping everyone close.

    The honest cost answer for all of these? There is no single calculator that gives you an accurate number. Every project deals with existing conditions in an existing home, and those conditions drive the cost. We take our clients’ budgets seriously — which means we get as many questions answered upfront as possible, so the scope of work reflects reality.

    The Moving vs. Renovating Math Most Homeowners Get Wrong

    Here’s where most families make a mistake: they compare the cost of a renovation against the list price of a bigger house, and decide moving is cheaper.

    That’s not the right comparison.

    Moving in Toronto comes with a long list of unavoidable costs that often get ignored: land transfer tax (provincial and municipal), realtor fees, legal fees, moving costs, and the very real premium you pay when you re-enter the market at a higher price point. Then there’s the intangible cost of leaving a neighbourhood you’ve already built a life in — schools, community, commute time.

    We always try to make sure our clients are evaluating the right numbers on both sides. We don’t care what they ultimately decide — as long as the decision is based on actual facts. If a family concludes that moving is genuinely the better choice, that’s fine. We’d rather help them reach an accurate conclusion than push them into a project that doesn’t make sense for their budget or their life.

    The funny thing? The number of families who call us back — or refer us to friends — because of this approach is remarkable. Turns out that giving people honest information, without a hard sell, pays off. We knew that going in.

    What Most Homeowners Get Wrong About “More Space” Projects

    The biggest mistake we see growing families make is getting too attached to a specific design before understanding what it will actually cost.

    Someone hires an architect, falls in love with renderings, and then gets a shock when the quotes come in. By that point, they’ve already spent money on design and emotionally committed to a vision. Making adjustments feels like failure.

    We work differently. We get involved in the design process early — sometimes before design even begins — to set realistic expectations for what a given budget can accomplish. Every design choice has a cost implication, and we flag those as they come up. We’ve saved our clients millions of dollars through value-engineering on “more space” projects: finding ways to achieve the same functional outcome with smarter decisions about materials, structure, and sequencing.

    The families who involve us early get projects that finish on time and on budget. The families who come to us after the design is locked in are the ones who end up with hard conversations and compromises.

    The BVM Approach: Solutions Engineering, Not Product Selling

    We describe our role as solutions engineers. That framing is intentional.

    When a family comes to us, we’re not starting from a predetermined answer. We’re listening to what they actually need, looking at what their property allows, understanding their budget, and then working backwards to find the best path forward.

    We’ve worked with a family in East York on a home addition project that ran through the full rise and fall of interest rates — over two years — to craft a scope of work that fit both their budget and their needs. We moved them in ahead of schedule and came in within the agreed budget. That kind of outcome doesn’t happen by accident. It happens because we’re embedded in the project from pre-construction through completion, managing the details that determine whether a project succeeds or overruns.

    We’ve also built completely separate dwelling units — a garden suite for a family to give their adult son independent living space in their backyard, allowing the parents to reclaim the space they needed inside the main home. It was a creative solution to a growing family situation that most people wouldn’t have considered.

    No two projects look the same. That’s the point. We customize every process to achieve each family’s specific goals within their actual budget.

    Frequently Asked Questions

    Q: Is it cheaper to add on to my house or move to a bigger one in Toronto?

    A: It depends — but moving costs more than most families account for. Land transfer tax, realtor fees, legal costs, and the premium on re-entering the market at a higher price point all add up. We always walk our clients through the real numbers on both sides before recommending anything.

    Q: How long does a home addition permit take in Toronto?

    A: For additions and secondary dwellings (like garden suites or laneway houses), expect a minimum of 3–4 months for permit approval — and 6–12 months is more realistic, especially if variances are triggered and the project has to go to the Committee of Adjustment. Interior renovations move through the City’s permit system much faster due to a dedicated fast-track process.

    Q: What’s the fastest way to add more living space to my Toronto home?

    A: An interior renovation or basement transformation typically gets through the permit process fastest and can be completed within a shorter overall timeline than any project that expands your home’s footprint. If speed is a priority, we’d start there.

    Q: How do I know if my home is a good candidate for a second-storey addition?

    A: It depends on your existing foundation, structure, and lot coverage. The only real way to know is to have someone who understands construction look at the property — not just an architect or designer, but someone who can evaluate the structural and cost implications of adding above.

    Q: Can BVM help if I don’t know which option is right for me?

    A: That’s actually where we start with most of our clients. We’ll walk through what your property allows, what your budget can realistically achieve, and which approach gives you the best outcome. No pressure, no predetermined answer.

    Ready to Talk About Your Project?

    If your family is outgrowing your home and you’re not sure whether to renovate or move, we’re the right first call. We’ll give you an honest assessment of your options — no hard sell, no predetermined answer. Just the information you need to make the right decision for your family and your budget.

    Related Reading:

  • When the Second Opinion Became the Only Choice

    When the Second Opinion Became the Only Choice

    How a sharp East York couple vetted three General Contractors, fired their front-runner, and ended up on the front page of the Toronto Star

    TLDR

    Alex and Katherine Hadjis bought their bungalow at 2 Chilton Road in East York knowing, from day one, they’d eventually add a second storey. When the time came, they brought BVM Contracting in to pressure-test their existing GC — not to hire us. Six months later, the 700 sq ft bungalow was transformed into a 1,500 sq ft, 3+1 bed, 2.5 bath two-storey home. The project wrapped on schedule, earned a Toronto Star feature, caught the attention of the Canadian Press, and launched a client relationship that’s still sending us referrals years later.

    That’s what happens when a client knows exactly what they want, and finds a team that can actually deliver it.

    Home Addition Project Information

    Project Type: Bungalow-to-two-storey home addition and conversion

    Location: East York, Toronto

    Scope: 3+1 bed · 2.5 bath · full second-storey addition

    Duration of Construction: 6 months

    Timeline of our services: Pre-construction through to completed construction

    Clients: Alex and Katherine Hadjis

    Project Cost: Inquire here

    Before and After

    They Didn’t Call Us First. They Called Us to Keep Someone Else Honest.

    Alex Hadjis is a Professional Engineer. A Senior Advisor in Engineering Construction. Katherine works at a prominent University in the Toronto area. They both grew up watching their parents navigate large renovation projects — they knew the questions to ask, the red flags to look for, and exactly how much it costs when a GC tells you what you want to hear instead of what’s true.

    When they were finally ready to lift their East York bungalow to two storeys, they had a front-runner GC they liked. But Alex being Alex, he wanted one more opinion — not because he was undecided, but because he wanted to put pressure on a process that deserved scrutiny. He called BVM Contracting.

    What happened next, Alex tells better than we could:

    It wasn’t a flashy presentation. It was Vince sitting across from a couple who knew exactly how to spot someone gaming a quote, and being completely straight with them. Transparent pricing. An itemized breakdown. Honest pre-construction process. No ambiguity.

    For Alex and Katherine, it wasn’t even close.

    Bottom line: When a client is sophisticated enough to know the difference between a pitch and a plan, there’s no substitute for being the most honest person in the room.

    The Client Who Already Knew the Process — and Raised the Bar Because of It

    Working with Alex and Katherine was unlike most client relationships we take on. Both sets of parents had completed major renovation projects. These weren’t first-time homeowners nervous about what they’d signed up for — they had what we call second-renovation experience: the accumulated knowledge that comes from watching a complex build up close, knowing what good looks like, and what to demand when it doesn’t show up. They knew what good looked like — and they expected it.

    That experience raised the bar on our end, and frankly, we welcomed it. Alex communicated directly and constantly. A running list of items, questions, and observations from someone who was genuinely engaged with what was being built.

    One moment captured everything about how we operate. Mid-project, after the second-floor washroom had already been framed, someone in Alex’s family flagged that the bathroom might benefit from being eight inches wider. The house was already up. Framing was done.

    Alex mentioned it to Vince.

    That’s what in-house labour makes possible. No calling a sub back in. No scheduling delays. No excuses. The crew was there, the decision was made, and it got done.

    Bottom line: A client who understands construction doesn’t slow you down — they sharpen your process and make the finished product better.

    Six Months. On Schedule. On Budget. Media Coverage.

    The project ran the full six months. No significant time delays. No cost surprises. Alex and Katherine moved back into a home that bore almost no resemblance to the 700 sq ft bungalow they’d left — a full two-storey house with 3+1 bedrooms, 2.5 bathrooms, and 1,500 sq ft of living space across the main and second floors. Alex finished the basement himself, rounding out a home that delivered exactly what they’d envisioned when they first bought the property.

    But the story didn’t end at move-in.

    Shortly after the project wrapped, the Toronto Star picked up the story. Alex’s hands-on involvement during the build — his experience as an engineer, his comfort working alongside the crew, and his willingness to get into the details — made for a compelling feature about homeowners who take an active role in their own renovations.

    The Canadian Press followed.

    That’s not a client who tolerated the process. That’s a client who loved it — and was willing to say so publicly, in national media.

    That distinction matters. You can think someone is honest before you trust them with your home. You know it after.

    Bottom line: When a project is run right — on schedule, on budget, with full communication — the client doesn’t just move in happy. They become your most credible advocate.

     Picture of BVM Contracting Clients Posing For Toronto Star Article about their East York Home Addition
    Picture of BVM Contracting Clients Posing For Toronto Star Article about their East York Home Addition

    After the Project: BVM Came Back Anyway

    A few months after Alex and Katherine moved in, an issue emerged with the rear patio door. The fix was needed. Vince came back.

    This isn’t unusual for us — it’s standard. But it’s worth naming directly, because in this industry, “the job is done” often means “you’re on your own now.” Our position is the opposite.

    Colleen reached out to Alex directly with a plan and a timeline:

    “Vince will be in next week to tackle the rear door. We have a plan of attack to correct it. Will be either Thursday or Friday. Will let you know closer to the date which it will be.”

    Alex’s response: “I had a great time doing our home reno project with you guys.”

    No frustration. No friction. Because when something needs attention, we attend to it — and clients notice.

    Bottom line: The job isn’t done when the crew packs up. It’s done when the client is genuinely happy. Sometimes that means coming back.

    What Alex Said — In His Own Words

    The Moment That Said Everything

    Years after the project wrapped, BVM Contracting would connect Alex with a journalist looking for homeowners who could speak to the value of hiring the right GC. He said yes without hesitation.

    He did the Toronto Star interview. He did the Canadian Press interview. He referred a client to BVM in 2025, wrote a Google review, and continued to stay in regular contact with the team.

    Alex and Katherine didn’t just get a house. They got exactly what he came looking for: a builder they trusted, a process they respected, and a result they are proud to show off.

    The reason experienced homeowners — people who’ve watched their parents navigate major renovations, who know every question to ask, and who can instantly recognize when a GC is telling them what they want to hear instead of what’s true — choose BVM Contracting is the same reason Alex and Katherine did. They recognized what honest looks like when they see it.

    Experienced home-building families choose BVM Contracting. Every time.

    Ready to Plan Your Home Addition?

    The 2 Chilton Road project is proof that a bungalow-to-two-storey addition — done right, with full transparency and an in-house team that can adapt on the fly — can be delivered on time and on budget, even when the client has high expectations and the experience to hold you accountable.

    If you’re thinking about adding a second storey, converting your existing footprint, or taking on a major home addition anywhere in East Toronto or the GTA, our pre-construction process will give you the clarity you need before committing to anything.

  • Setting Up a Rosedale Home Addition For Success

    Setting Up a Rosedale Home Addition For Success

    TL;DR: Before breaking ground on a Rosedale home addition, our client invested $40,000 + HST and 14 months on design and planning. This upfront investment included an interior demolition, full structural analysis, zoning review, heritage approvals, building design, committee of adjustment, and structural and mechanical coordination. The result: certainty about costs, timeline, and feasibility before the client committed to architectural design.

    Core Insights:

    • $13,500 structural analysis revealed the existing foundation could support a second story, saving over $200,000 versus new construction and a better layout for the home

    • Rosedale zoning bylaws (Exception RD 1281) made home addition more viable than new build due to setback restrictions and garage preservation

    • Heritage district and Committee of Adjustment approvals took 14 months (versus typical 8-12 months)

    • Two-phase construction strategy prevents rushed finish decisions for international client

    • A design & planning investment between $40,000-$60,000 + HST eliminates six-figure mistakes during construction

    Why We Reversed the Typical Process

    Most Toronto builders tell Rosedale homeowners to hire an architect first. We did the opposite.

    Our client purchased a neglected bungalow in one of Toronto’s most prestigious neighborhoods in 2024. The estate sale property had been poorly maintained for years, sticking out for all the wrong reasons. The client bought at a discount with one goal: bring it up to neighborhood standards.

    The first question: demolish and build new, or add onto the existing structure?

    This case study documents the 14-month planning process that answered that question before we connected the client with an architect. You’ll see the exact sequence of decisions, the upfront investments required, and the discoveries that would have caused major problems if we’d followed the typical architect-first approach.

    Step 1: The $13,500 Structural Analysis

    Before our client spoke to an architect, we needed to answer one fundamental question: could the existing structure support a home addition?

    The property presented specific challenges. The bungalow was structurally degraded from years of neglect. The garage sat over the property line. The lot measured 11.43 metres wide by 21.18 metres deep.

    Two paths forward:

    Option 1: Demolish everything and build new

    Option 2: Use the existing foundation and footprint, building up to create additional space

    The cost difference was going to be over $200,000. The real determining factor turned out to be zoning.

    We brought in our demolition team first. They stripped the interior completely, creating a blank slate for our engineering team to conduct a comprehensive structural review. This wasn’t a visual inspection or limited assessment. We evaluated every aspect of the home’s structural integrity because no one was living on site.

    Investment breakdown:

    • Full interior demolition: $12,000 + HST

    • Engineering and geotechnical review: $1,500 + HST

    • Total upfront cost: $13,500 + HST

    The engineering review revealed that the footings, foundation, and existing joists were more than suitable for a second-story addition. This discovery changed the entire trajectory of the project.

    Bottom line: Spending $13,500 before design work began gave us structural certainty that prevented six-figure mistakes later.

    Step 2: Why Zoning Bylaws Determined the Decision

    The structural assessment confirmed a home addition was physically possible. Rosedale operates under site-specific zoning bylaws that most contractors don’t understand until they’re deep into design.

    This property fell under Exception RD 1281, which includes specific provisions for home additions to houses built before October 15, 1953.

    The critical restriction: if we demolished the existing home to build new, current setbacks would be tightened. The house would become narrower than it already was. The garage sitting over the property line was grandfathered in under the existing structure. A new build would force us to eliminate it entirely.

    Homes in this neighborhood aren’t allowed to have integral garages within the main structure. Losing the detached garage meant losing an amenity that neighboring properties maintained.

    We created an updated survey of the property through our surveying partner. This survey, combined with our zoning review, showed that existing conditions favored the home addition approach over new construction.

    The preliminary budget gap of over $200,000 became less important than the zoning reality.

    A new build would have resulted in:

    • Narrower home with less interior floor space

    • No garage on the property

    • More restrictive setback requirements

    • Longer Committee of Adjustment process with less favorable precedents

    The home addition route preserved the existing footprint, maintained the garage, and worked within zoning provisions designed for additions to pre-1953 homes.

    Bottom line: Zoning analysis completed before architectural design prevented us from pursuing a new build that would have resulted in a smaller, less functional home.

    Step 3: Connecting With an Architect From a Position of Certainty

    When we connected our client with an architect, we had certainty.

    The $13,500 structural investment meant the client and our team were 100% confident to move forward with planning for the home addition. No stress or concerns about whether the project would work.

    This reverses how most residential projects unfold. Typically, homeowners hire an architect first, spend months in design, commit to the process emotionally and financially, then discover during contractor bidding that the project costs more than expected or faces structural constraints that weren’t identified upfront.

    We handed the architect specific parameters from day one:

    • Confirmed structural capacity for a second story

    • Defined zoning constraints under Exception RD 1281

    • Established that the home addition approach was optimal

    • Provided realistic budget ranges from our construction costing database

    • Identified the garage preservation requirement

    The architect could design with confidence because the foundational questions were already answered.

    Bottom line: Design and planning reversed the typical chicken-and-egg problem where clients hire designers before knowing if their project is financially viable or structurally possible.

    Step 4: Navigating Heritage District and NRRA Approvals

    Rosedale projects don’t require only standard building permits. This property sits within the North Rosedale Heritage Conservation District, which adds approval layers that most Toronto neighborhoods don’t face.

    We iterated on the design multiple times during planning. The initial design concept had to be modified to satisfy both Toronto Heritage and the North Rosedale Residents’ Association (NRRA).

    Major design changes required:

    • Switched from the original roof system to a mansard roof design

    • Updated the front facade to align with heritage character guidelines

    • Identified the most cost-effective approach to meet heritage and NRRA standards

    The heritage and NRRA review process took approximately 2 months. This was on top of the Committee of Adjustment process required for zoning variances.

    When we first sat down with this client and ran our preliminary timeline analysis, our database showed that Rosedale projects typically take 8 to 12 months for approvals. This specific project took 14 months from initial conversation to permit in hand.

    The extended timeline created carrying costs for the client. Every month the project doesn’t start is another month of property taxes, insurance, and financing costs without the ability to occupy or generate value from the property.

    We knew this going in. We communicated the realistic timeline based on our experience with heritage district approvals and Committee of Adjustment processes in this specific neighborhood.

    Bottom line: Heritage district projects in Rosedale take 8-14 months for approvals. Planning for this timeline prevents surprise carrying costs.

    Step 5: Designing a Two-Phase Construction Strategy

    Our client lives in a different country. Managing a construction project remotely requires a different approach than typical owner-occupied renovations.

    We developed a two-phase construction strategy:

    Phase 1: Construction to Drywall

    This phase includes all structural work, mechanical systems, electrical rough-in, plumbing, insulation, and drywall installation. Getting to this stage allows the property to be reassessed for value, which enables the client to extract additional capital to fund Phase 2.

    Phase 2: Finishes and Interior Design

    This phase covers all finish selections, interior design elements, fixtures, flooring, cabinetry, and final details.

    The goal isn’t to stop after drywall. We’re actively procuring the Phase 2 budget while executing Phase 1. With a tight start date for construction, we needed to get moving without forcing the client into rushed decisions about finishes and interior design elements.

    This approach prevents the common problem where homeowners make expensive finish selections under time pressure, later regretting choices they felt forced to make quickly.

    Our construction management platform gives this client transparency into what’s happening every week on the project. Living in another country doesn’t mean being disconnected from the process. The platform keeps communication tight and keeps the client accountable for decisions that need to be made on schedule.

    Bottom line: Phased budgeting prevents rushed finish decisions while allowing the client to access additional capital after Phase 1 completion.

    The Discovery That Changed the Project Direction

    Looking back at this 14-month planning process, the structural integrity of the existing home was the biggest discovery.

    Many builders would have recommended demolition without conducting comprehensive structural review. The property looked rough. The neglect was visible. The default assumption would be to start fresh.

    We took a methodical approach to prove which direction made the most sense for this client’s needs.

    The $13,500 investment in demolition and engineering analysis revealed that the bones of the house were well-suited for a home addition. The footings were solid. The foundation was sound. The existing joists could support the additional load.

    This discovery, combined with the zoning analysis showing that a new build would result in a smaller, less functional home without a garage, made the decision clear.

    Bottom line: Methodical structural analysis prevented a demolition decision that would have cost $150,000-$200,000 more and resulted in an inferior outcome.

    What Does Design & Planning Cost For A home Addition?

    This Rosedale project required multiple consultants and analyses to get the project properly set-up:

    • Updated property survey

    • Full interior demolition for structural access

    • Comprehensive engineering review

    • Geotechnical analysis

    • Zoning analysis and bylaw interpretation

    • Drafting and submission of multiple iterations of plans to the NRRA, heritage, and C of A.

    • Preliminary budget modeling from our construction database

    • Heritage district consultation

    • Committee of Adjustment application preparation

    For a homeowner considering a similar project in a heritage neighborhood, the realistic total investment for design and planning ranges from $40,000 to $60,000 + HST, but could be more if you decide to engage with interior design planning services.

    That’s a significant number before permit drawings exist.

    This investment provides certainty. It eliminates the chicken-and-egg problem where you need to hire a designer before knowing if your project is financially viable or physically possible. At the end of the day proper planning is not a cost, it is a strategic investment that gives you the certainty to get your project constructed.

    The alternative is spending months in design, becoming emotionally committed to a vision, then discovering during contractor bidding that the project costs 30% to 50% more than expected or faces structural constraints that require major redesigns.

    We’ve seen that scenario repeatedly. Design teams create drawings without understanding true construction costs or structural realities of the existing building. Clients fall in love with the design. Then reality hits during contractor selection.

    The upfront planning investment turns what most people view as a cost into a strategic investment. You’re buying information that prevents six-figure mistakes during construction.

    Bottom line: $40,000-$60,000 + HST spent on design and planning eliminates the risk of discovering deal-breaking problems after you’re emotionally and financially committed to a design direction.

    What This Means for Heritage Neighborhood Projects

    If you’re considering a home addition or new build in Rosedale, Forest Hill, or any Toronto heritage conservation district, the joint construction budgeting and zoning analysis needs to happen before you commit to design.

    You need a deliberate direction before contacting a design team. Without that foundation, you’re having conversations based on assumptions rather than data.

    The typical process puts the cart before the horse. Hire an architect, spend months designing, then find out what it costs and whether it’s possible given your property’s constraints.

    We enable our clients to enter the design phase with enough information to make informed decisions.

    For this Rosedale project, that meant:

    • Knowing the existing structure could support a home addition

    • Understanding the zoning bylaws that made the addition approach superior to new construction

    • Having realistic budget parameters from our database before design began

    • Anticipating the 14-month timeline for heritage and Committee of Adjustment approvals

    • Planning the two-phase construction approach to manage financing and decision-making

    We’re breaking ground in 2026 with a client who understands exactly what they’re building, what it will cost, and how long it will take.

    That certainty came from investing in planning before committing to design.

    Frequently Asked Questions

    How long does design & planning take for a Rosedale home addition?

    Design and planning for heritage district projects in Rosedale typically takes 8 to 12 months. This specific project took 14 months from initial conversation to permit in hand because of extended Committee of Adjustment and heritage review processes.

    Why demolish the interior before getting an architectural design?

    Full interior demolition allows comprehensive engineering review of the existing structure’s footings, foundation, and joists. This $12,000 investment provides certainty about whether the existing structure supports a home addition before spending months in architectural design.

    What is Exception RD 1281 in Rosedale?

    Exception RD 1281 is a site-specific zoning bylaw that includes provisions for home additions to houses built before October 15, 1953. These provisions allow additions under less restrictive setback requirements compared to new builds, making additions more favorable than demolition and new construction on some properties.

    How does a two-phase construction approach work?

    Phase 1 takes the project to drywall (structural work, mechanical systems, electrical, plumbing, insulation). This allows property reassessment and capital extraction. Phase 2 covers finishes and interior design. The approach prevents rushed finish decisions while maintaining construction momentum.

    What consultants are needed before architectural design in a heritage district?

    Proper design and planning in heritage districts requires surveyors (updated property survey), structural engineers (foundation and load capacity review), geotechnical engineers (soil analysis), zoning specialists (bylaw interpretation), and heritage consultants (district compliance review).

    Why did the garage location affect the new build versus addition decision?

    The existing garage sat over the property line, grandfathered in under the current structure. A new build would have forced elimination of the garage entirely because Rosedale doesn’t allow integral garages within the main home structure, and new setback requirements wouldn’t accommodate a detached garage on this lot size.

    How does Proper design & planning prevent budget overruns?

    Design and planning identifies structural constraints, zoning limitations, and realistic construction costs before architectural commitment. This prevents the common scenario where clients spend months in design, fall in love with a vision, then discover during contractor bidding that the project costs 30% to 50% more than expected.

    What carrying costs should heritage district homeowners plan for during approvals?

    During the 8-14 month approval process for heritage district projects, homeowners pay property taxes, insurance, and financing costs without ability to occupy or generate value from the property. Planning for this extended timeline prevents surprise carrying costs.

    Key Takeaways

    • Pre-design structural analysis ($13,500) revealed the existing Rosedale bungalow could support a second-story addition, saving over $200,000 versus new construction

    • Rosedale zoning bylaws (Exception RD 1281) made home addition more viable than new build because new construction would have resulted in tighter setbacks, narrower home, and loss of grandfathered garage

    • Heritage district and Committee of Adjustment approvals took 14 months (versus typical 8-12 months), creating carrying costs that need to be planned for upfront

    • Complete design and planning investment ranges from $40,000-$60,000 + HST for heritage neighborhood projects, covering survey, demolition, engineering, zoning analysis, and heritage consultation

    • Two-phase construction strategy (Phase 1 to drywall, Phase 2 finishes) prevents rushed decisions while allowing property reassessment and capital extraction between phases

    • Reversing the typical architect-first process eliminates the chicken-and-egg problem where clients commit to design before knowing if their project is financially viable or structurally possible

    • Upfront planning investment prevents six-figure mistakes during construction by identifying structural constraints, zoning limitations, and realistic costs before architectural commitment
